Water System Modernization
In progressRetiring the old plant, purchasing treated water from the City of La Cygne, a new water tower, and expanding distribution lines to more homes.
In progress Updated October 2026 Target completion: April 2027
At a glance
Time-sensitive
No closures or shutoffs scheduled right now
Check back — this list updates as work is scheduled.
See all closures & shutoffs on Construction → Resident action
Construction affecting your property or street?
Report it on the Construction tab so the City can track and follow up.

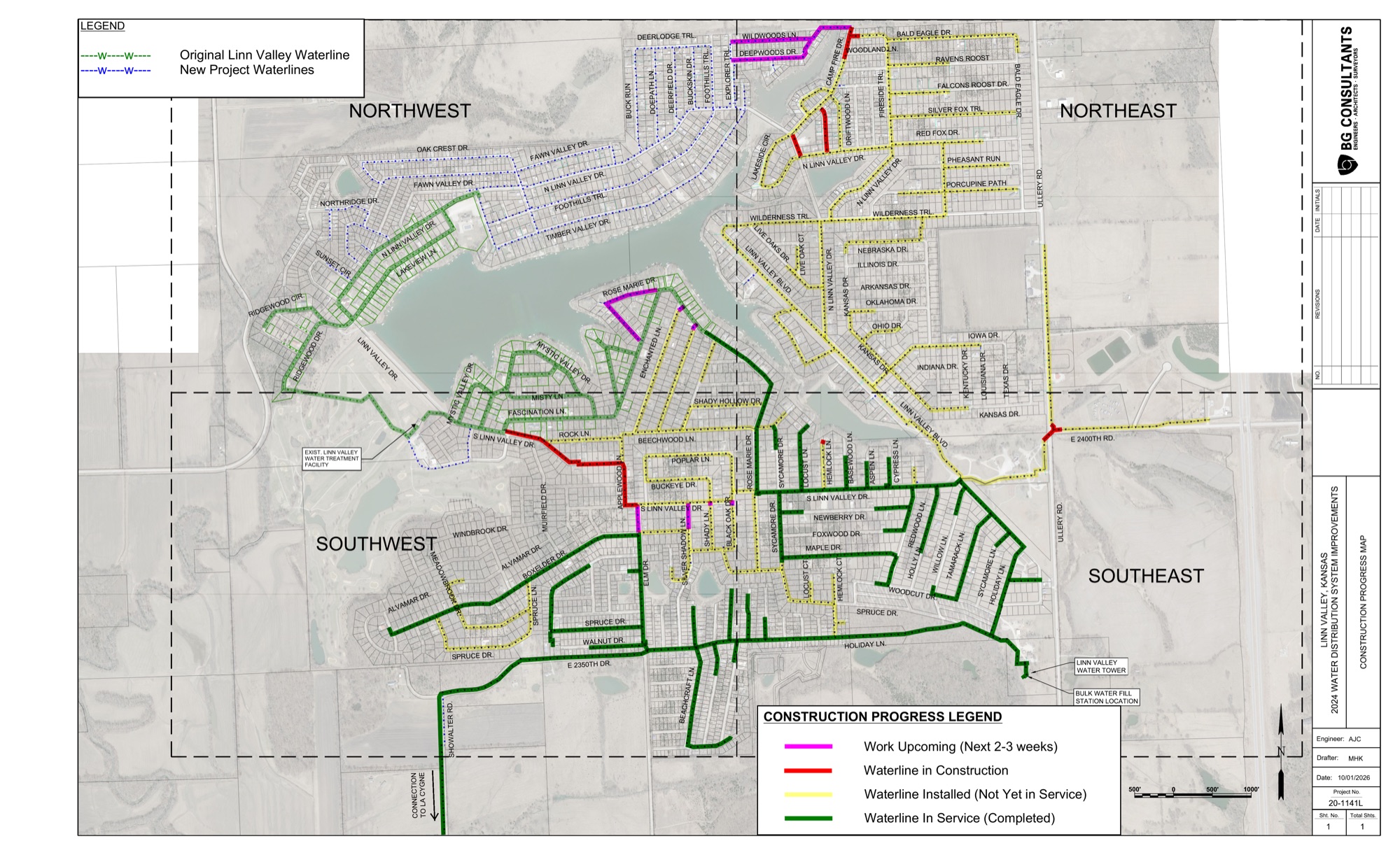

Report a water-project issue →Overall progress
69% complete · slightly behind the 73% pace mark
As of September 30, 2026, by construction value. Target completion remains April 2027.
Behind pace — target unchangedMilestone snapshot
4 of 7 milestones complete In progress: Phase 2 — distribution lines and meters underway Next: Distribution main complete — target by April 10, 2027
Latest update
October 2026 About 69% complete overall, slightly behind the pace mark. Phase 1 (transmission main, booster station, fill station) is about 99% complete and in final punch-list; Phase 2 (distribution lines & meters) is about 64% complete, with crews on Applewood Ln, Rose Marie Dr, Camp Fire Dr, and Deepwoods Dr, and new meters going in around Kansas, Oklahoma, Ohio, and Iowa Dr. Lines near Knutt, Maple, Sycamore, Spruce Dr, and Meadowbrook passed testing and are now in service (9 new meters). Target completion remains April 2027.Newest
